Finland’s Permit and Supervisory Agency (LVV) has demanded that Tuike Finland suspend environmentally significant preparatory work at planned Google data center sites in Muhos and Kajaani. The agency says that altering the land before environmental reviews are complete could make it harder to assess impacts and consider alternatives. The demand does not establish that work has stopped or that either project is canceled, as Euronews reported.
The agency issued its demand Tuesday, Oct. 6. Tuike Finland, Google’s Finnish project company, must provide a written response by Oct. 14. The covered work must be suspended immediately and no later than Oct. 23, and remain suspended until the environmental impact assessment procedures are complete.
The assessments are still underway. LVV said reports for both projects were expected to be completed during 2026. Finland’s environment minister has said delays are likely, but no revised schedule or decision to abandon either site has been established.
Which work does Finland’s demand cover?
The demand applies to preparatory measures that significantly alter the environment. It is not a blanket instruction to stop every activity at either site. Its scope is tied to the environmental effect of the work, rather than to all planning or project activity.

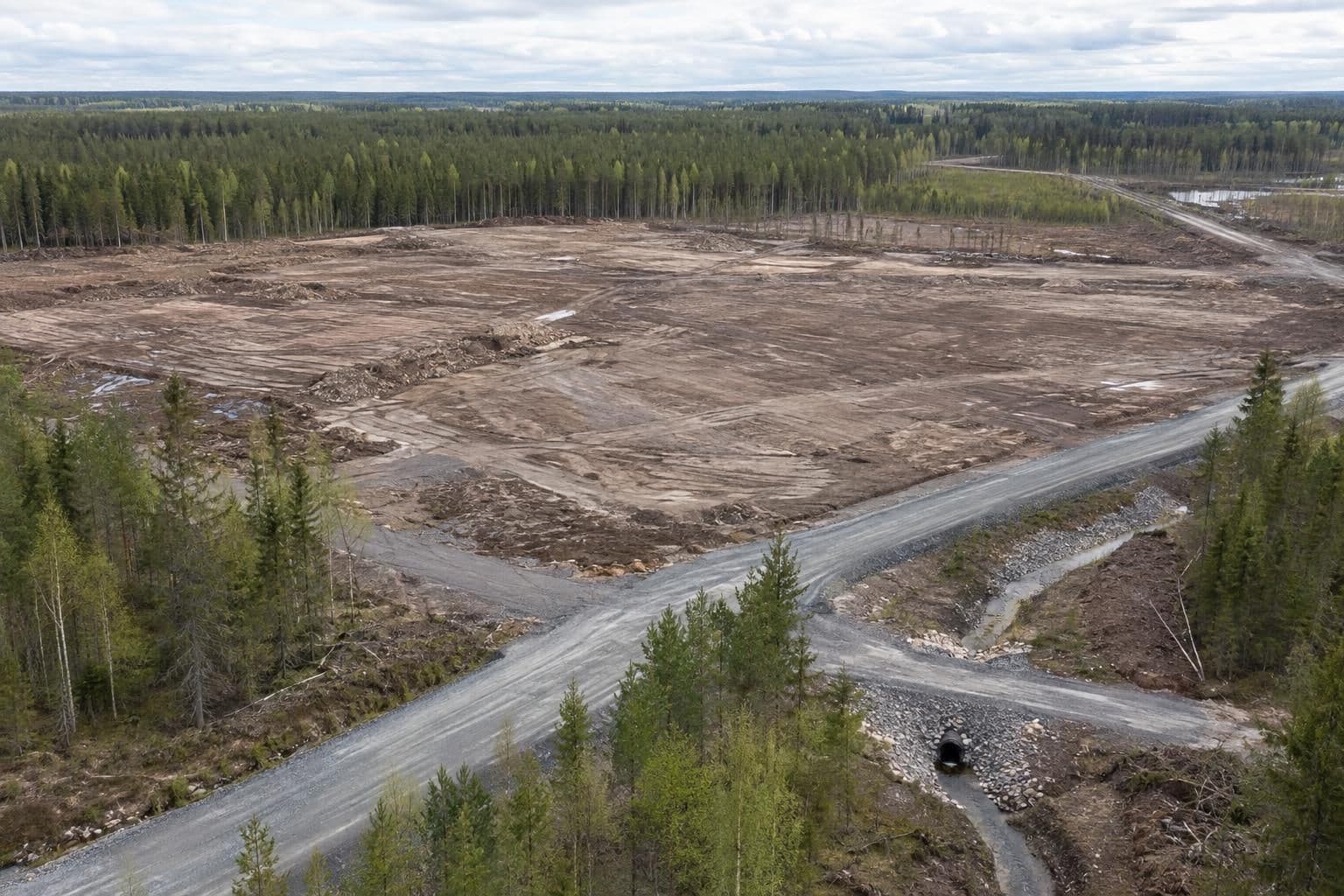

LVV said information available to it indicated that work already carried out included removing trees, stripping topsoil, building site roads and storage areas, changing ditches and culverts, and arranging stormwater systems. The agency says those measures can alter the environment that the assessments are meant to examine.
The issue is also procedural. Environmental impact assessments are intended to examine likely significant effects before decisions and substantial preparation tied to a project. LVV says major changes made before the reviews finish could weaken that preventive role and limit the ability to compare alternatives or avoid harmful effects.
That does not settle what the completed assessments will find, or which project designs could proceed. The agency’s demand is a temporary constraint on a defined category of preparation while the assessments remain unfinished, not a final decision on either data center.
What environmental concerns prompted the demand?
LVV’s notice lists the kinds of site work it says have occurred, but does not give a total for cleared forest. Hanna Halmeenpää, chair of the Finnish Association for Nature Conservation, told AFP that more than 300 hectares had been logged, Euronews reported. Halmeenpää also said some of the affected areas were sites the association believed should be preserved.
That area estimate and description are the nature-conservation association’s account, not figures attributed to LVV. The available information does not establish an independently assessed total for forest loss or a complete accounting of ecological effects at the two locations. The agency’s stated basis for the demand is that significant changes may precede and interfere with the assessment process; the association’s logging claim is separate.
The distinction matters because the agency’s concern is not simply whether land has been cleared. It says that preparatory work can change the conditions being assessed and narrow the scope for weighing other options. The completed reviews are still expected to identify and evaluate the projects’ likely effects.
What has Google said, and how does Finland’s minister view the decision?
Google spokesperson Sondre Ronander said in a statement sent to AFP, reported by Euronews, that the company understood the concerns and had fallen short of its own standards in this case. Ronander said Google would review LVV’s findings and follow its guidance.
Free newsletter
Get the morning briefing
Start each day with the AI stories that matter and why — a short, free email from our newsroom.
Google has also said it acted in good faith and carried out environmental surveys and other measures. It said it planned tree planting across 130 hectares at Muhos. The available reporting does not establish that the planting has taken place or that it addresses the concerns behind the agency’s demand.
Environment and Climate Minister Sari Multala said the projects would likely be delayed because of the assessment problems. She also said companies operating in Finland must comply with the law. Her comments state the minister’s view; the agency’s demand is not a court ruling, and it does not itself establish that either project has been canceled.
The next immediate test is Tuike Finland’s response. LVV says it may consider administrative enforcement if the company does not comply, but it has not announced that it has imposed an enforcement measure.
How much of Google’s Finland investment is affected?
The two sites are part of a wider investment plan, but the suspension demand names only Muhos and Kajaani. Google announced plans to invest at least €13 billion in Finnish digital infrastructure over 2027–2028, spanning Hamina, Kajaani, Muhos and Vaala, along with supporting infrastructure. Google described the plan as its largest single investment in Europe.
That figure is an announced future investment, not an independently verified amount already spent. Nor does the agency’s demand establish that the full plan is suspended. The notice does not name Hamina or Vaala, and the available information does not quantify how much the limits on work at Muhos and Kajaani could affect Google’s broader infrastructure plans.
For the two named projects, the immediate consequence is that significant land-altering preparation must be suspended while the assessments are completed. Multala expects delays, but no updated project timetable has been announced. The duration of the constraint will depend in part on completion of the reviews and the agency’s next steps after receiving Tuike Finland’s response.
What happens next?
Tuike Finland’s written response is due Oct. 14. LVV has set Oct. 23 as the latest date for suspension of the covered work and says it may consider administrative enforcement if the company does not comply. No formal enforcement measure has been announced.
The assessment reports for Muhos and Kajaani were expected during 2026, according to LVV. The record does not establish when the reviews will be completed, how long the suspension will last, or what findings the assessments will make about the projects.
Comments
Comments are written by readers. They are not reporting or opinion from AI News.
Share your view on this story. Criticise ideas and public records, not other readers.
Comments appear once a moderator approves them.
Community guidelines
More in our terms and privacy policy.
Comments close on October 14, 2026.
No comments yet. Start the conversation.
