What does Cipher’s 20-year Barber Lake commitment actually lock in?

Cipher says an unnamed lab committed to enter a separate 10-year lease after Fluidstack; data halls were expected to arrive in phases from Q4 2026 through Q1 2027.

Compute Desk · AI News

4 min readComments

Ground-level view of the Barber Lake data-center site near Colorado City, Texas.

Cipher reports that Barber Lake now has an aggregate contracted term of 20 years: Fluidstack’s lease is followed by an unnamed AI lab’s binding commitment to enter a separate 10-year lease. That extends the stated commitment to the site, but does not establish that the later lease has been signed or that the data center is complete.

Cipher amended its Fluidstack lease and made the follow-on commitment on Sept. 24, 2026. It said individual data halls were expected to be delivered in phases from the fourth quarter of 2026 through the first quarter of 2027, with rent starting as each hall is delivered.

What does the 20-year Barber Lake term include?

The 20 years describe two successive arrangements, not one lease already signed with a single tenant. In its Sept. 24 filing, Cipher said a leading AI lab made a binding commitment to enter a separate 10-year lease after Fluidstack’s term. The filing describes the future lease’s economic terms as substantially consistent with Fluidstack’s, but does not call it an executed lease.

Cipher’s announcement the next day described the change as increasing the contracted lease duration from 10 years to 20 years. The commitment is meaningful, but the filing does not name the lab or spell out every condition governing the future lease. The information released establishes a commitment to enter it, not that it has begun.

Fluidstack’s original lease had a 10-year base term and two five-year extension options. The later AI-lab commitment is separate from those options. Cipher’s reported 20-year duration counts Fluidstack’s term followed by the lab’s binding commitment to enter a 10-year lease; the filing does not say the lab is exercising a Fluidstack option. Cipher’s original lease filing sets out the base term and options.

Who are Cipher, Fluidstack and Google in the arrangement?

Cipher, through its subsidiary Cipher Barber Lake LLC, is the project developer and landlord. Fluidstack USA II Inc. is the initial lessee, meaning the company renting the facility. The original transaction materials describe Fluidstack as an AI cloud platform that builds and operates high-performance computing clusters. The original deal announcement describes Fluidstack’s role.

Barber Lake is a data-center project near Colorado City, Texas. Cipher’s 2025 annual report described planned gross capacity of 300 megawatts: 244 megawatts for Phase I and 56 megawatts for Phase II. Cipher distinguishes gross capacity from critical IT load, and the planned figures do not establish that the full site has been delivered. Cipher’s annual report gives the project figures.

Google’s disclosed role belongs to the earlier Fluidstack arrangement. Cipher’s 2025 filing says Google agreed to backstop certain Fluidstack obligations, with conditions and options described in that filing; it puts the covered obligations at $1.4 billion. That disclosure does not identify Google as the follow-on tenant or say it guarantees the unnamed lab’s commitment or all Barber Lake revenue. The filing on Google’s support arrangement describes the backstop.

Does a 20-year commitment mean the facility is ready?

No. The length of a lease commitment and the construction status are different measures. Cipher’s September filing said tenant design changes led to a revised, phased delivery schedule. It expected individual data halls to arrive from the fourth quarter of 2026 through the first quarter of 2027, with rent beginning hall by hall upon delivery.

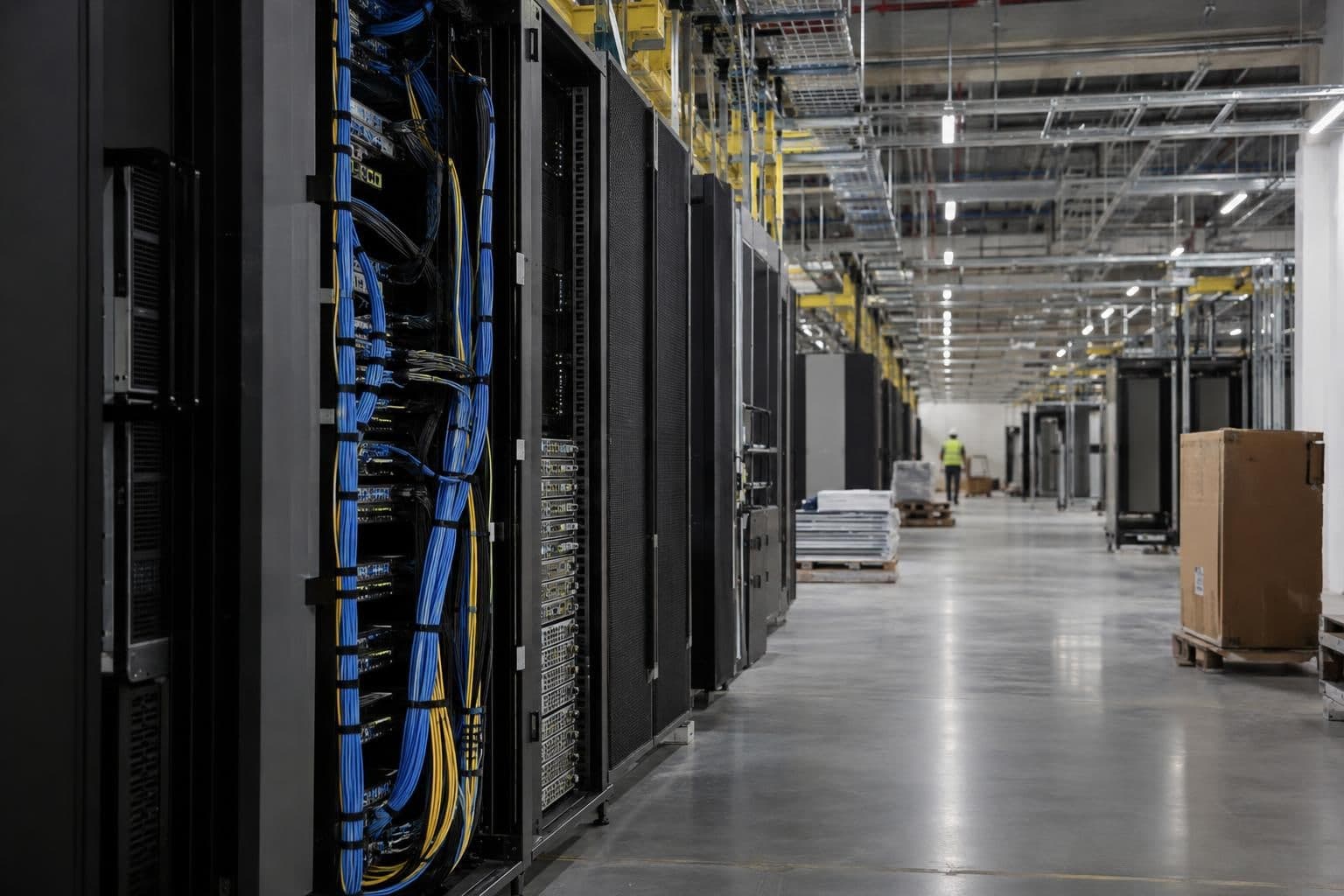

Network racks installed in a partially occupied data hall at Barber Lake

Cipher had reported some activity at the site before that forecast. In an Aug. 4 update, it said Fluidstack had begun beneficial use, including partial occupancy and the deployment of network racks, while work toward completion continued. Cipher’s August update describes that status. Partial use and ongoing construction can coexist; the update did not say all halls or all planned capacity were ready.

Cipher expected the first rent to begin in the fourth quarter of 2026. Its filing presents that as a forecast, not confirmation that rent has started. Because rent is tied to delivery of each hall, the 20-year figure should not be read as rent already accruing across a finished facility.

Free newsletter

Get the morning briefing

Start each day with the AI stories that matter and why — a short, free email from our newsroom.

Free. One email a day, one-click unsubscribe. See our privacy policy.

What do the revenue and cost figures actually show?

Cipher said the follow-on commitment represents about $5.2 billion in incremental aggregate contracted revenue. Its announcement put Barber Lake’s total contracted revenue at more than $9 billion after the agreements, compared with $3.8 billion before them. These are Cipher’s projections, not cash it has already received. The cited disclosures do not independently verify the revenue estimates or establish how much capacity customers are using.

The construction-cost terms also affect the economics. Cipher said it will bear the first $359.3 million of costs above the initial lease budget. Under the disclosed framework, the tenant is to reimburse 50% of qualifying costs beyond that threshold through additional rent over the contracted term; Cipher’s filing does not say the tenant covers all overruns.

The unresolved details are concrete: Cipher has not named the lab or disclosed every condition for the later lease, and its hall-delivery dates remain expectations. Whether the follow-on lease is entered into and whether the halls arrive on the forecast schedule are separate milestones from the reported 20-year commitment.

Comments

Comments are written by readers. They are not reporting or opinion from AI News.

Share your view on this story. Criticise ideas and public records, not other readers.

Comments appear once a moderator approves them.

Community guidelines
  • Be civil. Criticise ideas, arguments and public records, not other readers.
  • No harassment, threats, hate speech or dehumanising language, and nothing that targets private individuals.
  • Don't share personal information, such as email addresses or phone numbers, yours or anyone else's.
  • Stay on topic. No advertising, spam or repeated posts.
  • Comments with links may wait for a moderator.
  • We publish comments as written or not at all, and we may remove comments that break these guidelines.

More in our terms and privacy policy.

Comments close on October 17, 2026.

No comments yet. Start the conversation.

Related coverage

More from Chips & Compute

More Compute
